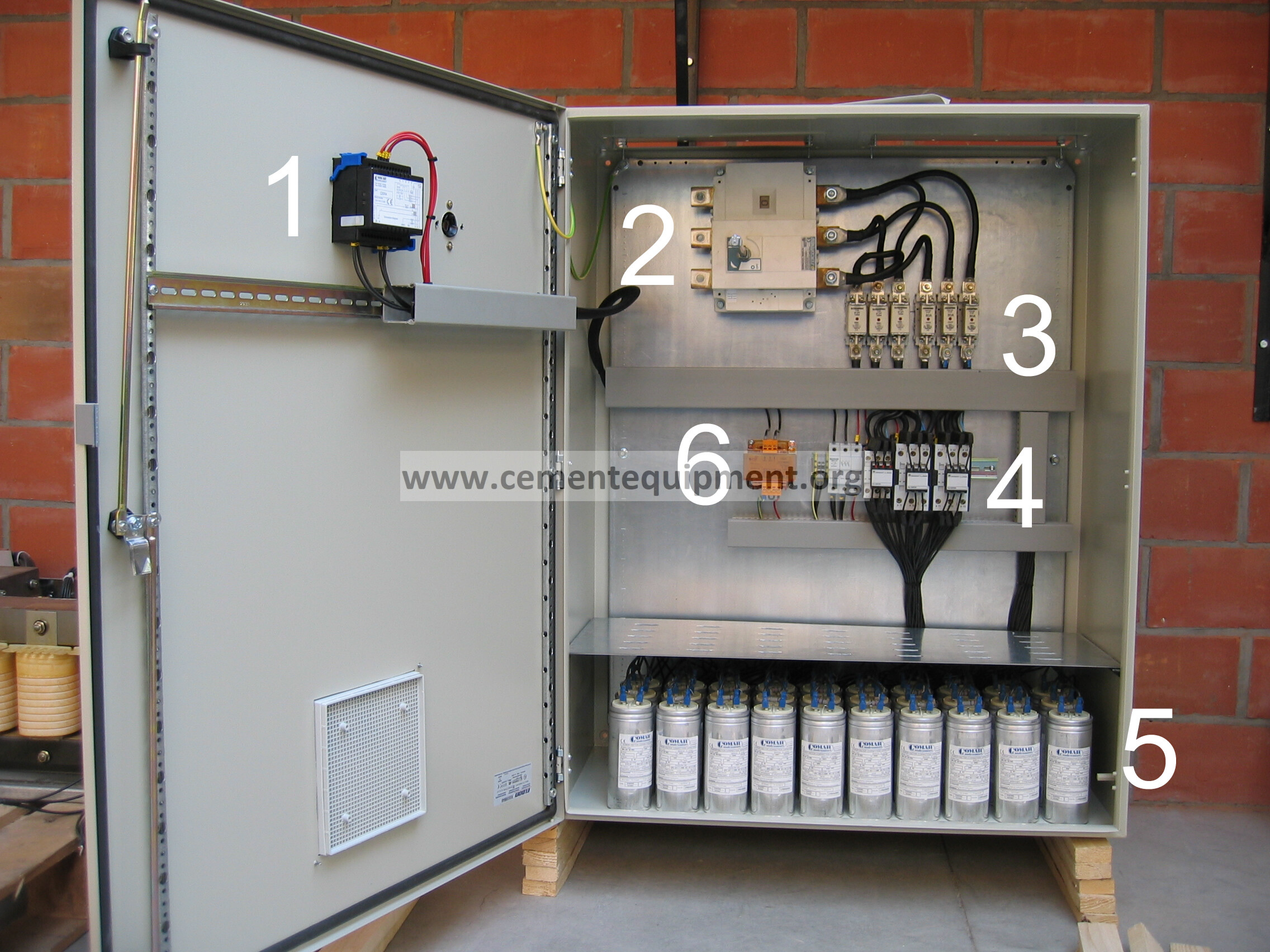

Automatic power factor correction capacitor bank with regulator, fuses, contactors and capacitor units used to diagnose capacitor-step hunting

Power Factor Capacitor Bank Step Hunting

Previous Post
Next Post

Automatic power factor correction capacitor bank with regulator, fuses, contactors and capacitor units used to diagnose capacitor-step hunting
Automatic power-factor correction capacitor bank showing the regulator, fuses, contactors and capacitor units. Wikimedia Commons public-domain image by Beuhri. Diagnose hunting by comparing controller demand with the actual kvar contribution of each step.

Quick answer

Capacitor-bank step hunting—steps repeatedly switching on and off—usually means the power-factor controller is reacting to a marginal setpoint, unstable load, incorrect CT signal, switching delay, failed capacitor step or harmonic condition. Diagnose power factor, kvar demand, step status, CT polarity/ratio, controller target/deadband, switching delay and capacitor current before changing settings. Repeated switching shortens contactor and capacitor life.

Problem / job

Automatic power-factor correction steps chatter or cycle frequently although plant production is relatively steady.

Evidence

Capture power factor, kvar, phase currents, controller step commands, actual capacitor currents, switching interval, CT data and major load changes.

Decision

Separate controller/CT problems from genuine fast load changes, failed steps, contactor issues and harmonic/resonance effects.

As-found evidence capture

Trend power factor and kvar demand together with each capacitor-step command. Identify whether one particular step repeatedly enters and leaves service or whether the whole bank hunts. Compare actual capacitor current after each command with the expected behavior.

Capacitor banks contain hazardous stored energy. Inspection and testing must follow site electrical isolation, discharge verification and qualified-person procedures.

Seven-step diagnostic workflow

1. Confirm the load is actually stable

Large cycling motors, crushers, mills or welders can make legitimate kvar demand move across the controller threshold. If plant load is truly varying, hunting may be a control-band problem rather than a component failure.

2. Verify CT polarity, ratio and location

Incorrect CT orientation, phase reference or ratio can make the regulator calculate reactive power incorrectly. Review wiring against the approved scheme before changing the target power factor.

3. Review target, deadband and switching delay

A very tight target/deadband or short switching delay can make the controller reverse decisions repeatedly near the threshold. Compare with the controller/OEM design settings.

4. Verify each capacitor step actually delivers kvar

A contactor may close while a fuse, capacitor unit or connection is failed. Compare step current and kvar contribution. A weak/dead step can make the regulator repeatedly call for more correction.

5. Inspect contactors and switching devices

Worn capacitor-duty contactors or thyristor modules can fail intermittently. Review switching counts, heating and electrical condition under approved maintenance procedures.

6. Check harmonic conditions

High harmonic voltage/current can change capacitor current and create resonance or protection events. If detuned reactors are fitted, verify their condition and investigate power quality before increasing capacitance.

7. Prove stable correction over the load cycle

After correcting CT, settings or failed steps, trend several production cycles. Confirm power factor remains in the approved range without excessive step switching.

Evidence-to-decision table

EvidenceLikely directionNext check
One step cycles repeatedlyStep contribution or threshold issueStep current, fuse, capacitor and contactor
All steps hunt near target PFDeadband/delay or CT issueController settings and CT wiring
Command ON but no kvar/current increaseFailed stepFuse, contactor, capacitor unit
Hunting follows large motor cyclingReal reactive-load variationLoad profile and switching delay
Capacitor current abnormally high/distortedHarmonic/resonance concernPower-quality assessment

Use step contribution to separate a controller problem from a weak capacitor step

Trend controller demand, commanded step number and the actual phase current or kvar contribution immediately after each switching event. A healthy step should make a repeatable contribution under comparable voltage and load. If the controller commands a step ON but the measured reactive contribution is absent or much lower than the bank baseline, investigate that step’s fuses, contactor or thyristor switch, capacitor unit, connections and detuning reactor where fitted before changing the regulator target.

If every step contributes normally but the bank still toggles around the setpoint, the problem is more likely in load volatility, CT/reference configuration, deadband, switching sequence or switching delay. This distinction is important because widening a deadband can reduce visible hunting while leaving a failed capacitor step undiscovered.

Field verification sequence after the repair

  1. Confirm CT ratio, polarity, phase reference and regulator wiring against the approved drawing.
  2. Record power factor and kvar demand with the bank temporarily stable before the next automatic decision.
  3. Observe each commanded step and verify that actual capacitor current/reactive contribution appears.
  4. Trend the regulator through a normal cement-plant load cycle that includes large motors or mills starting and stopping where relevant.
  5. Check that steps do not reverse repeatedly around one threshold and that no one step shows abnormal current, heating or protection activity.
  6. If harmonic distortion is significant or detuned reactors are installed, review the plant power-quality assessment and reactor/capacitor condition before increasing compensation.

If hunting returns after a short stable period, look for the repeating trigger instead of repeatedly changing the target power factor. Common repeat mechanisms include one intermittent contactor, a failing fuse, CT wiring disturbed during maintenance, a large cyclic load crossing the decision threshold, or a regulator that sees distorted current under changing harmonic conditions.

Return-to-service acceptance criteria

Accept the bank when actual capacitor-step current matches expected contribution, controller feedback is correct, power factor remains within the plant target and switching frequency is reasonable through representative production.

Common mistakes

Do not tighten the power-factor target until hunting disappears. Do not assume a contactor command means a healthy capacitor step. Do not change CT wiring or work inside the bank energized. Do not ignore harmonics. Finally, use the regulator, capacitor and plant electrical design criteria rather than generic PF settings.
